Compilers - Lecture 4

January 31, 2021

Lecture 4

Instruction Scheduling (part 3)

Code:

a:  loadAI  r0,@w   => r1
b:  add     r1,r1   => r1
c:  loadAI  r0,@x   => r2
d:  mult    r1,r2   => r1
e:  loadAI  r0,@y   => r3
f:  mult    r1,r3   => r1
g:  loadAI  r0,@z   => r2
h:  mult    r1,r2   => r1
i:  storeAI r1      => r0,@w

Note: store can cause aliasing issue, so for our projects we will always use storeAI

Local (forward) List Scheduling

Step 1. Build the dependence graph

Step 2. Determine priorities

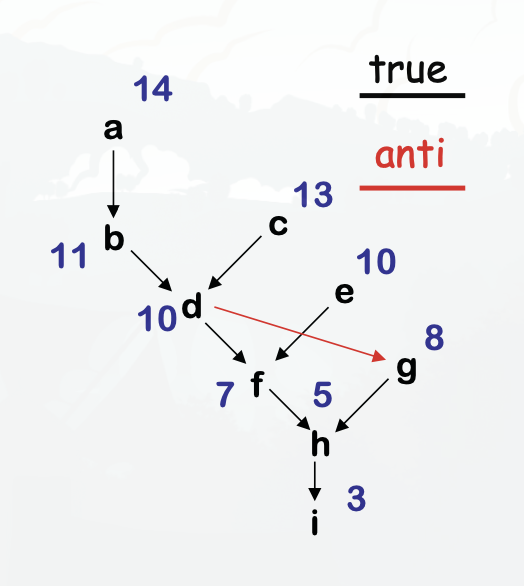

  • Find the longest latency-weighted path

Example

  • You can schedule the instructions efficiently by prioritizing scheduling instructions in the critical path
  • Instructions that can be queued are stored in the Ready Set
  • Instructions that are currently queued are in the Active Set
  • You then traverse the graph, using the sets, and can generate more efficient, faster code.

Example:

Cycle Ready Set Active Set What happened
a, c, e Move a to active set
0 c,e a
1 e a, c Move c to active set
2 a, c, e Move e to active set
3 b, c, e Remove a from active set since it has finished, and add b to the ready set since it depended on a. Move b to active set
4 d, e Remove b and c from active set since they have finished, and add d to the ready set since it depended on b. Move d to the active set
5 d Remove e from the active set since it has finished. We can’t add f yet since it’s still waiting on d
6 f g Remove d form the active set, and add f and g to the ready set. We schedule g first because it has a higher latency-weighted path.
7 g, f Move f to the active set
8 g, f Nothing we can do here
9 h Remove g and f from the active set since they have both finished. Add h to the ready set, and move it to the active set.
10 h Nothing to do, waiting on h to finish
11 Remove h from the active set, and add i to the ready set. Move i to the active set
12 Nothing to do, waiting on i to finish

Generated Code

0:  a: loadAI r0,@w => r1
1:  c: loadAI r0,@x => r2
2:  e: loadAI r0,@y => r3
3:  b: add    r1,r1 => r1
4:  d: mult   r1,r2 => r1
5:
6:  g: loadAI r0,@z => r2
7:  f: mult   r1,r3 => r1
8:
9:  h: mult   r1,r2 => r1
10:
11: i: storeAI r1 => r0,@w
12:

By using the dependency graph and List scheduling, we turned 20 cycles into 14!

Algorithm

Cycle <- 0
Ready <- leaves of P
Active <- empty

while (Ready ∪ Active != empty)
  if (Ready != empty) then
    remove an op from Ready
    S(op) <- Cycle
    Active <- Active ∪ op

  Cycle <- Cycle + 1

  for each op ∈ Active
    if (S(op) + delay(op) <= Cycle) then
      remove op from Active
      for each successor s of op in P
        if (s is ready) then
          Ready <- Ready ∪ s

Formalisms

  • A correct schedule maps each n in N into a non-negative integer representing its cycle number such that
  1. S(n) >= 0, for all n in N (obviously)
  2. If (n1, n2) in E, S(n1) + delay(n1) <= S(n2)
  3. For each type t, there are no more operations of type t in any cycle than the target machine can issue

The length of a schedule S, denoted L(S), is:

  • L(S) = max(n in N)(S(n) + delay(n))

The goal is to find the shortest possible correct schedule. S is time-optimal if L(S) <= L(S1), for all other schedules S1.

Note: We are trying to minimize execution time here.

What’s so difficult?

Critical points

  • All operands must be available
  • Multiple operations can be ready
  • Operands have multiple predecessors Together, these issues make scheduling hard (NP-Complete)

Local scheduling is the simple case

  • Restricted to straight-line code (single basic block)
  • Consistent and predictable latencies
